Agile Project Management: Best Practices and Methodologies

Agile is an iterative and incremental solution development methodology that focusses on delivering value to the customer by seeking customer feedback, embracing and adapting to change and striving for improvement continuously.  The Agile Manifesto along with the Agile Principles are at the heart and in the spirit of the various Agile Frameworks which are being adopted increasingly by Enterprises as their Project Management Framework. Agile Project Management Agile Project Frameworks Scrum, Kanban, XP, SAFe are some of the Agile Frameworks that are have replaced traditional waterfall and predictive approaches of Software Project Management. Long standing philosophies such as Lean and practices like TDD, BDD, Pair Programming etc are leveraged into these frameworks.  Scrum and Kanban are the most popular Agile Frameworks used today with Scrum being used in almost 58% of Agile Projects as per the Annual State of Agile Report 2020. Scrum uses a time-boxed iterative approach to develop incremental products and solutions with each iteration spanning 2 /3/ 4 weeks. Kanban does not have time-boxed iterations and focusses on establishing flow of work by controlling WIP (Work In Progress) and is well suited for maintenance, support or Helpdesk projects. In this article we will discuss about Agile Project Management using Scrum. Before looking at the Scrum framework briefly, we need to understand two very important aspects in which Agile Project Management is different from traditional Waterfall – Scope and Estimation. The Iron Triangle Unlike traditional projects, in Agile the schedule and the cost involved for a project is largely fixed. The scope is the variable entity and is adjusted as per the latest information and feedback from customers. The focus is on delivering value rather than following a rigid and detailed plan laid out at the beginning of the project. In Scrum for example, every Sprint runs for a fixed time-box and changes to agile team composition is not recommended. Iron TriangleEstimation – Relative Sizing Agile recommends “relative sizing“of work items that enables predictability rather than complex estimation techniques striving for accuracyAgile EstimationIn the Image 2 above people on the road looking at the buildings would most likely converge on the fact that Building A is the smallest of the three, Building B is twice that of A , Building C is the tallest – almost 3 times that of Building A. This can be done quickly at the first glance. In contrast if they must estimate the actual height of the building in metres it is prone to error and there are going to be a lot of differences. The power of relative sizing lies in the fact that we do not strive for accuracy (in the example the height of the building in metre) but focus on sizing the work and achieving predictability over the course of time. Instead of complex effort estimation in man days/hours, High level Epics /Features are usually estimated by the T-shirt sizes (Small, Medium, Large, X-Large) and Stories are estimated and given “Story Points” that follow the  modified Fibonacci sequence (1, 2, 3, 5, 8, 13, 20, 40, 100) Brief overview of Scrum Framework The Scrum framework comprises of the roles, events and artifacts and describe how these entities interconnect with each other in order to implement the framework.   Scrum follows an iterative approach where development cycles are 2 /3/4 weeks long. At the end of every iteration an incremental version of the product/solution is ready to be shipped. Each event /artifact/role in the scrum framework serves a purpose and furthers the goal of Agile project development. Let us go over each of them in detail. Scrum FrameworkRelease Planning Although Agile does not recommend detailed rigid plans laid out well in advance, it does not altogether forego planning. There is a high-level Release Planning at the beginning of the release and shorter detailed Sprint planning events at the beginning of every Sprint. Having short planning phases throughout the project implementation helps to adapt to changes and course correct at responsible milestones. For large organizations where multiple scrum teams work towards developing a solution, planning and timing a release is very important. The organization might choose to time the release as per Customer(s) demand or at an established cadence (e.g every quarter) or in alignment with certain events (e.g tradeshow/ compliance deadline etc). The release planning is a look ahead planning with an objective of arriving at the scope of the release considering the schedule and budget as fixed components of the iron triangle. The two important inputs required for this event is a prioritized product backlog and the velocity of the teams participating in the release (historic data for teams running on agile and an informed guesstimate for the new teams.) The teams will roughly plan out their upcoming sprints (if a release spans 12 weeks there can be 5 sprints of 2 weeks each followed by a 2 week “hardening sprint”). At the end of this planning event there is a list of prioritized features that can be accommodated in the release and a high-level plan for each sprint.  Scrum Roles  The Scrum Master, Product Owner and the development team form the “3 Amigos”. There is a good amount of trust and a healthy relationship amongst the people playing these three roles. Healthy conflicts and disagreements between these three entities is expected and bound to occur. At these times the teams are guided by the Scrum Values of Respect, Courage and Openness. At all times the scrum team practices commitment and focus to achieve the Sprint Goals and further the Agile Values and Principles. The Three AmigosResponsibilites of Each RoleResponsibilites of Each RoleScrum Artifacts Product Backlog: A Product Backlog consists of all the new features, changes to the existing features, technical requirements such as infrastructure upgrades or architectural requirements that might become a part of the product. This is continuously refined by the product manager, product owners and the scrum teams. The purpose of the refinement is to prioritize, split and detail the contents of the backlog so that the first set of items in the backlog are ready to be picked by the teams during their Sprint Planning. Sprint Backlog: The items picked from the Product Backlog and committed by the team for a Sprint constitutes the Sprint Backlog. It is unlikely to change during the course of the Sprint/iteration. A product owner could introduce changes in consensus with the team. Multiple changes to the sprint backlog within the Sprint timeframe should be discouraged and root cause analysis has to be performed during retrospective meeting if this happens often. Product Increment: The work items ready to be delivered at the end of a Sprint is a Product Increment. It has to be in a potentially shippable condition and meet the definition of done as defined by the team and has to be accepted by the Product Owner as complete and ready for release. Scrum Ceremonies / Events EventFrequency of OccurrenceDescriptionBacklog RefinementContinuousEpics and features are estimated and broken down to Stories. Stories are broken down and acceptance criteria are added. The Backlog is prioritized and ordered.Sprint PlanningOnce at the beginning of a Sprint lasting up to 4 hours for a 2-week SprintThe top priority stories that are refined and ready for the team is picked. The teams estimate the stories and load the sprint up to their Capacity. The historic Velocity and the current capacity (leaves and holidays adjusted) are taken into account for loading the Sprint.SprintCan be 2 /3/4 weeks longNot recommended to change the Sprint duration often. The cadence once set has to run for at least 3 to 4 Sprints to collect data for becoming predictable.Daily Stand upEvery day for 10-15 minutesThe Scrum Master facilitates the event and the team shares the happenings of previous day, strategize and plan for current day. Impediments /concerns are raised.Sprint ReviewOnce at the end of the SprintThe working software is demonstrated to stakeholders. Based on Sprint Review and outcomes, inputs and changes are done to the Product BacklogSprint RetrospectiveOnce at the end of the SprintThis is the "sacred time of learning" for the entire team. Issues and problems faced during the Sprint are discussed, root cause analysis performed and team arrives at solutions to resolve and prevent in future. The team identifies areas of improvement.Scrum ceremonies or eventsScrum Values  Courage - Every team member feels safe to fail and learn, to seek help, to say ‘no’ and question something that is going wrong. Commitment – Commits to the Sprint goals as a team. Does not overcommit.  Focus - Aims to complete what is started and steer away from distractions and unprioritized / "shoulder tap" work. Limits Work in Progress. Openness - Seeks and values feedback and opportunities to learn. Makes impediments, failures and learnings visible. Respect - Team collaborates and acknowledges the work and achievements of every member. Builds trust. Quantitative Metrics Organizations can collect and measure various metrices. The below metrics are most likely to be captured by most of the projects and add value. Burn Down Chart: The Burn down chart is a run chart of the rate at which the scrum team completes work within a sprint in terms of number of Story points completed per day.  Velocity: Velocity is the number of story points completed and accepted by the Product owner within a Sprint.  Collecting data on velocity enables teams, releases and projects become more predictable. Other than the absolute velocity, another important perspective of velocity data is % of story points delivered against total story points committed by the team. Velocity cannot be used to compare the efficiency of teams since 3 story points for one team is different for another team. Quality related Metrics: Quality related metrics like number of defects reported in production after release, number of defects in Integration testing are captured to understand the level of Quality. Armed with quantitative data the teams can come up with ways to improve Quality.  Quality related MetricsAgile Projects at Scale While the scrum framework prescribes the guidelines to run an Agile team, the same can be extrapolated and mechanisms can be put in place to scale it to multiple teams. SAFe and Nexus offer frameworks to scale Agile in large Enterprises. Large projects in Enterprises involve multiple teams and dependencies with other functions, divisions and with third party partners, suppliers and vendors. The complexities of large solutions and programs require Governance, Compliance, Stakeholder Management, Streamlined Communication, Conflict and Risk management. The Agile Program Management Office takes care of establishing Agile at scale with the help of Senior Leadership, Agile Coaches and Change Agents (who could be the Agile Project Managers and Scrum Masters). Role of the Agile Project Manager The Agile PM plays an important role when doing Agile at scale in large enterprises. While working towards a seamless project release by interfacing with the multiple scrum teams and various stakeholders, the Agile PM also plays a key role in the Agile transformation journey of the Enterprise.   Agile at ScaleAgile Project ManagerScrum Master and Agile PM Roles Agile Projects at scale requires the role of a Scrum Master for the internal functioning of the team and the Agile PM for aligning multiple teams and orchestrating the activities of a Release. Agile PMScrum MasterTakes care of the facilitation, risk management, conflict management, handling of impediments that span multiple teams and external stakeholders.  Engages closely with Senior Leadership, Product Managers, Product Owners, Scrum Masters to ensure smooth implementation of the current release, forward plans for the subsequent release and co-ordinates the Post production activities of the previous release. Facilitates the Scrum of Scrums synch meetings at a regular cadence (every week).  The Agile PM guides the scrum masters to resolve risks and impediments within the team if and when escalated. Takes care of these activities within the scrum team. The Scrum Master focuses on the current sprint and current release. Facilitates Scrum Ceremonies. Participates in the Scrum of Scrums and updates if the team is on track to meet the Sprint Objectives and if there is any change/ risk foreseen. During this meeting the Scrum Masters raise any impediments /risks/concerns they are unable to resolve and need help with. Release Management Continuous Integration and Deployment: With incremental versions of the product after every iteration from multiple teams early continuous integration is the need of the hour. Investing in an automated Continuous deployment into the Staging or Production environment is encouraged so that the latest version of the product is release ready. Enterprises are increasingly using toggle configurations to switch on/off a set of features so that the release can be done for a particular market segment or can be timed with an important milestone like a tradeshow. By separating the deployment and actual release, there is a lot of risk avoided. The actual product release can be announced at the right time – as per Market demand/ after a robust Beta has been done and feedback incorporated/timed with a compliance deadline or important milestone like tradeshows. Post-production Support: Releasing working software at regular intervals is not the end of the road. Customer Support, training and customer documentation where required is necessary and these activities should also come under the purview of an Agile Working environment.  Beta and Canary Release: Large Enterprises engage with Beta customers to get focussed feedback on the product before a wider market release. Solutions and products can also be released to a particular market segment or a subset of users alone. This is called a “Canary Release”. This phased approach rather than a big bang approach will ensure the risk level is reduced and the quality of the product and credibility of the Enterprise is maintained.  How is an Agile PM different from the Conventional PM  The roles and responsibilities of a conventional Project Manager is now distributed amongst the Scrum Teams, Scrum Master, Product Owner and the Agile Project Manager. But the most important but subtle difference between the Conventional PM and Agile PM is the mindset.  The Agile PM is a Servant Leader who wants to create a self-empowered self-organized team. He/she creates an agile environment where everyone is accountable, there is no fear of failure but the willingness to learn and continuously improve. The Agile PM avoids the traditional Command and Control approach where decisions are taken for the teams. .  There is also a conscious effort to decentralize decision making so that decisions are taken closer to where work is done. There is always an emphasis for visualization of work and transparency. Go-to Traits for a Successful Agile Project Self-Organized Teams: Self-organized teams that are empowered and largely self-sufficient is an important facet of Agile. Teams are used to conventional ways of working where they look up to their superiors for decision making. Decentralized decision making will help largely to create empowered teams Responsive to Change: creating empowered teams enable them to respond to change responsibly with minimum red tape. Quick Feedback Loops: Agile thrives when there are quick feedback loops established so that teams can adapt to change based on informed decisions. Continuous Improvement: Learning from the past and resolving not to repeat mistakes is an important facet of Agile teams. Retrospection at end of every iteration and release is highly recommended. Business Agility: It would not be enough if engineering teams are agile and churn out software seamlessly. “Building the product right “is not sufficient and the teams should “Build the right product”. Solutions and products have to meet the customer needs and solve Customer Problems.  All functions such as product management, marketing, sales HR have to come into the purview of Agile Principles and Values to achieve the kind of Business Agility that is required to be Customer Centric and deliver value. In conclusion, Agile is a paradigm shift from the phased traditional waterfall methods which run on detailed plans laid well ahead. Agile Project Management is the need of the hour considering the rapidly changing market scenario, disruptive technologies and the ever- growing competition.  Before embarking on Agile projects organizations have to invest the time and effort to create a conducive Agile Work environment. The bare basics of Agile training and creation of small Agile teams (5 to 9 members recommended) with the vision to make the teams self-organized need to be in place. Agile Coaches and Change agents have to be identified to ensure the Agile transformation starts and keeps pace with small strides and does not die a natural death with teams, business and leadership falling back to traditional waterfall methods in the name of agile.

Agile Project Management: Best Practices and Methodologies

7K
Agile Project Management: Best Practices and Methodologies

Agile is an iterative and incremental solution development methodology that focusses on delivering value to the customer by seeking customer feedback, embracing and adapting to change and striving for improvement continuously.

The Agile Manifesto along with the Agile Principles are at the heart and in the spirit of the various Agile Frameworks which are being adopted increasingly by Enterprises as their Project Management Framework.

Agile Project Management

Agile Project Frameworks

Scrum, Kanban, XP, SAFe are some of the Agile Frameworks that are have replaced traditional waterfall and predictive approaches of Software Project Management. Long standing philosophies such as Lean and practices like TDD, BDD, Pair Programming etc are leveraged into these frameworks.

Scrum and Kanban are the most popular Agile Frameworks used today with Scrum being used in almost 58% of Agile Projects as per the Annual State of Agile Report 2020.

Scrum uses a time-boxed iterative approach to develop incremental products and solutions with each iteration spanning 2 /3/ 4 weeks. Kanban does not have time-boxed iterations and focusses on establishing flow of work by controlling WIP (Work In Progress) and is well suited for maintenance, support or Helpdesk projects.

In this article we will discuss about Agile Project Management using Scrum. Before looking at the Scrum framework briefly, we need to understand two very important aspects in which Agile Project Management is different from traditional Waterfall – Scope and Estimation.

The Iron Triangle

Unlike traditional projects, in Agile the schedule and the cost involved for a project is largely fixed. The scope is the variable entity and is adjusted as per the latest information and feedback from customers. The focus is on delivering value rather than following a rigid and detailed plan laid out at the beginning of the project. In Scrum for example, every Sprint runs for a fixed time-box and changes to agile team composition is not recommended.

Iron TriangleIron Triangle

Estimation – Relative Sizing

Agile recommends “relative sizing“of work items that enables predictability rather than complex estimation techniques striving for accuracy

Agile EstimationAgile EstimationIn the Image 2 above people on the road looking at the buildings would most likely converge on the fact that Building A is the smallest of the three, Building B is twice that of A , Building C is the tallest – almost 3 times that of Building A. This can be done quickly at the first glance. In contrast if they must estimate the actual height of the building in metres it is prone to error and there are going to be a lot of differences. The power of relative sizing lies in the fact that we do not strive for accuracy (in the example the height of the building in metre) but focus on sizing the work and achieving predictability over the course of time.

Instead of complex effort estimation in man days/hours, High level Epics /Features are usually estimated by the T-shirt sizes (Small, Medium, Large, X-Large) and Stories are estimated and given “Story Points” that follow the  modified Fibonacci sequence (1, 2, 3, 5, 8, 13, 20, 40, 100)

Brief overview of Scrum Framework

The Scrum framework comprises of the roles, events and artifacts and describe how these entities interconnect with each other in order to implement the framework.

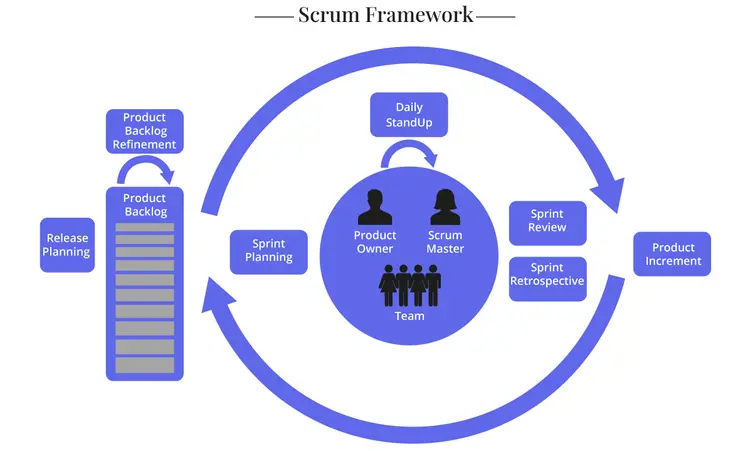

Scrum follows an iterative approach where development cycles are 2 /3/4 weeks long. At the end of every iteration an incremental version of the product/solution is ready to be shipped. Each event /artifact/role in the scrum framework serves a purpose and furthers the goal of Agile project development. Let us go over each of them in detail.

Scrum FrameworkScrum FrameworkRelease Planning

Although Agile does not recommend detailed rigid plans laid out well in advance, it does not altogether forego planning. There is high-level Release Planning at the beginning of the release and shorter detailed Sprint planning events at the beginning of every Sprint. Having short planning phases throughout the project implementation helps to adapt to changes and course correct at responsible milestones.

For large organizations where multiple scrum teams work towards developing a solution, planning and timing a release is very important. The organization might choose to time the release as per Customer(s) demand or at an established cadence (e.g every quarter) or in alignment with certain events (e.g tradeshow/ compliance deadline etc)The release planning is a look ahead planning with an objective of arriving at the scope of the release considering the schedule and budget as fixed components of the iron triangle.

The two important inputs required for this event is a prioritized product backlog and the velocity of the teams participating in the release (historic data for teams running on agile and an informed guesstimate for the new teams.) The teams will roughly plan out their upcoming sprints (if a release spans 12 weeks there can be 5 sprints of 2 weeks each followed by a 2 week “hardening sprint”). At the end of this planning event there is a list of prioritized features that can be accommodated in the release and a high-level plan for each sprint.

Scrum Roles

The Scrum Master, Product Owner and the development team form the “3 Amigos”. There is a good amount of trust and a healthy relationship amongst the people playing these three roles. Healthy conflicts and disagreements between these three entities is expected and bound to occur. At these times the teams are guided by the Scrum Values of Respect, Courage and Openness. At all times the scrum team practices commitment and focus to achieve the Sprint Goals and further the Agile Values and Principles.

The Three AmigosThe Three Amigos

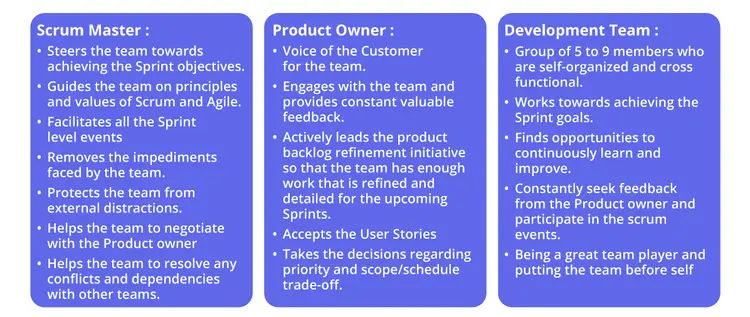

Responsibilites of Each RoleResponsibilites of Each RoleResponsibilites of Each RoleScrum Artifacts

  • Product Backlog: A Product Backlog consists of all the new features, changes to the existing features, technical requirements such as infrastructure upgrades or architectural requirements that might become a part of the product. This is continuously refined by the product manager, product owners and the scrum teams. The purpose of the refinement is to prioritize, split and detail the contents of the backlog so that the first set of items in the backlog are ready to be picked by the teams during their Sprint Planning.
  • Sprint Backlog: The items picked from the Product Backlog and committed by the team for a Sprint constitutes the Sprint Backlog. It is unlikely to change during the course of the Sprint/iteration. A product owner could introduce changes in consensus with the team. Multiple changes to the sprint backlog within the Sprint timeframe should be discouraged and root cause analysis has to be performed during retrospective meeting if this happens often.
  • Product Increment: The work items ready to be delivered at the end of a Sprint is a Product Increment. It has to be in a potentially shippable condition and meet the definition of done as defined by the team and has to be accepted by the Product Owner as complete and ready for release.

Scrum Ceremonies / Events

EventFrequency of OccurrenceDescription
Backlog RefinementContinuousEpics and features are estimated and broken down to Stories. Stories are broken down and acceptance criteria are added. The Backlog is prioritized and ordered.
Sprint PlanningOnce at the beginning of a Sprint lasting up to 4 hours for a 2-week SprintThe top priority stories that are refined and ready for the team is picked. The teams estimate the stories and load the sprint up to their Capacity. The historic Velocity and the current capacity (leaves and holidays adjusted) are taken into account for loading the Sprint.
SprintCan be 2 /3/4 weeks longNot recommended to change the Sprint duration often. The cadence once set has to run for at least 3 to 4 Sprints to collect data for becoming predictable.
Daily Stand upEvery day for 10-15 minutesThe Scrum Master facilitates the event and the team shares the happenings of previous day, strategize and plan for current day. Impediments /concerns are raised.
Sprint ReviewOnce at the end of the SprintThe working software is demonstrated to stakeholders. Based on Sprint Review and outcomes, inputs and changes are done to the Product Backlog
Sprint RetrospectiveOnce at the end of the SprintThis is the "sacred time of learning" for the entire team. Issues and problems faced during the Sprint are discussed, root cause analysis performed and team arrives at solutions to resolve and prevent in future. The team identifies areas of improvement.

Scrum ceremonies or events

Scrum Values

  • Courage - Every team member feels safe to fail and learn, to seek help, to say ‘no’ and question something that is going wrong.
  • Commitment – Commits to the Sprint goals as a team. Does not overcommit.
  • Focus - Aims to complete what is started and steer away from distractions and unprioritized / "shoulder tap" work. Limits Work in Progress.
  • Openness - Seeks and values feedback and opportunities to learn. Makes impediments, failures and learnings visible.
  • Respect - Team collaborates and acknowledges the work and achievements of every member. Builds trust.

Quantitative Metrics

Organizations can collect and measure various metrices. The below metrics are most likely to be captured by most of the projects and add value.

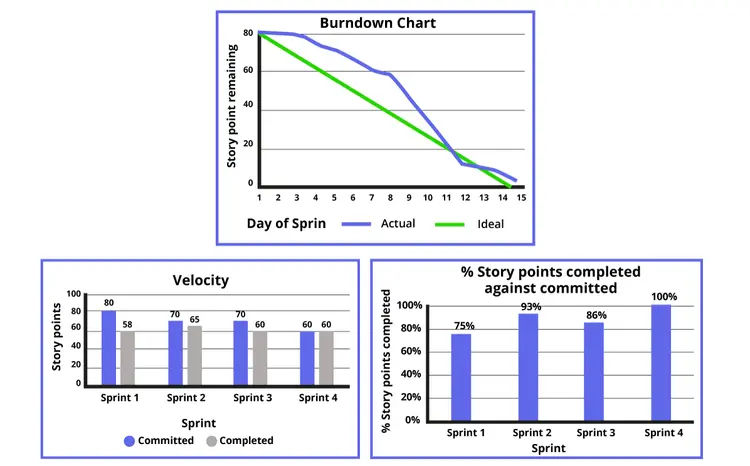

  • Burn Down Chart: The Burn down chart is a run chart of the rate at which the scrum team completes work within a sprint in terms of number of Story points completed per day
  • Velocity: Velocity is the number of story points completed and accepted by the Product owner within a Sprint.  Collecting data on velocity enables teams, releases and projects become more predictable. Other than the absolute velocity, another important perspective of velocity data is % of story points delivered against total story points committed by the team. Velocity cannot be used to compare the efficiency of teams since 3 story points for one team is different for another team.
  • Quality related Metrics: Quality related metrics like number of defects reported in production after release, number of defects in Integration testing are captured to understand the level of Quality. Armed with quantitative data the teams can come up with ways to improve Quality.

Quality related MetricsQuality related Metrics

Agile Projects at Scale

While the scrum framework prescribes the guidelines to run an Agile team, the same can be extrapolated and mechanisms can be put in place to scale it to multiple teams. SAFe and Nexus offer frameworks to scale Agile in large Enterprises.

Large projects in Enterprises involve multiple teams and dependencies with other functions, divisions and with third party partners, suppliers and vendors. The complexities of large solutions and programs require Governance, Compliance, Stakeholder Management, Streamlined Communication, Conflict and Risk management. The Agile Program Management Office takes care of establishing Agile at scale with the help of Senior Leadership, Agile Coaches and Change Agents (who could be the Agile Project Managers and Scrum Masters).

Role of the Agile Project Manager

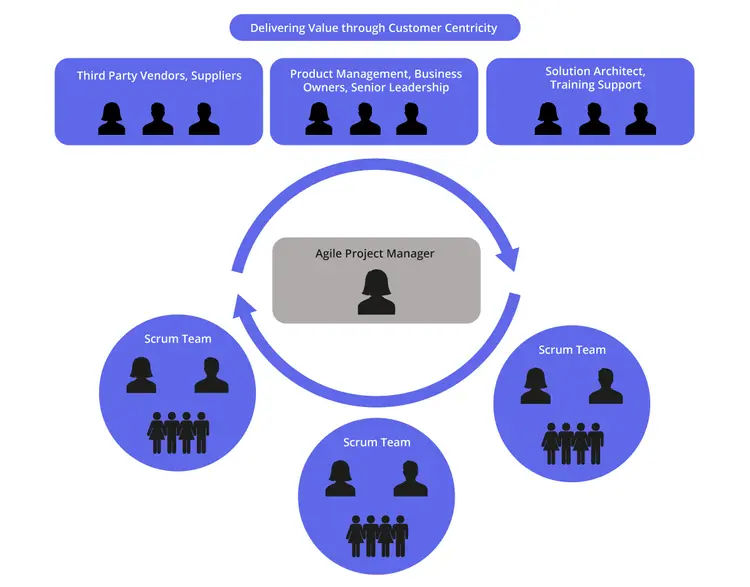

The Agile PM plays an important role when doing Agile at scale in large enterprises. While working towards a seamless project release by interfacing with the multiple scrum teams and various stakeholders, the Agile PM also plays a key role in the Agile transformation journey of the Enterprise.

Agile at ScaleAgile at Scale

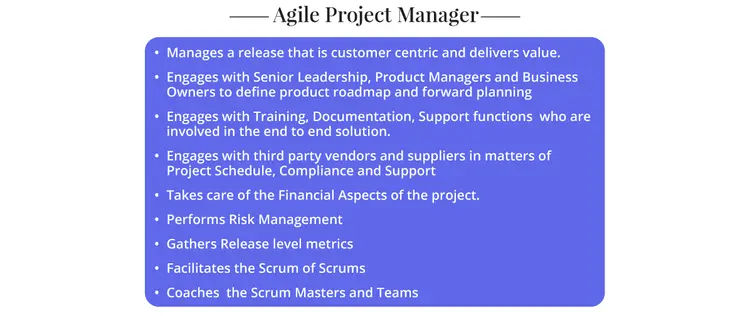

Agile Project ManagerAgile Project ManagerScrum Master and Agile PM Roles

Agile Projects at scale requires the role of a Scrum Master for the internal functioning of the team and the Agile PM for aligning multiple teams and orchestrating the activities of a Release.

Agile PMScrum Master

Takes care of the facilitation, risk management, conflict management, handling of impediments that span multiple teams and external stakeholders.

Engages closely with Senior Leadership, Product Managers, Product Owners, Scrum Masters to ensure smooth implementation of the current release, forward plans for the subsequent release and co-ordinates the Post production activities of the previous release.

Facilitates the Scrum of Scrums synch meetings at a regular cadence (every week).

The Agile PM guides the scrum masters to resolve risks and impediments within the team if and when escalated.

Takes care of these activities within the scrum team.

The Scrum Master focuses on the current sprint and current release.

Facilitates Scrum Ceremonies. Participates in the Scrum of Scrums and updates if the team is on track to meet the Sprint Objectives and if there is any change/ risk foreseen.

During this meeting the Scrum Masters raise any impediments /risks/concerns they are unable to resolve and need help with.

Release Management

  • Continuous Integration and Deployment: With incremental versions of the product after every iteration from multiple teams early continuous integration is the need of the hour. Investing in an automated Continuous deployment into the Staging or Production environment is encouraged so that the latest version of the product is release ready. Enterprises are increasingly using toggle configurations to switch on/off a set of features so that the release can be done for a particular market segment or can be timed with an important milestone like a tradeshow. By separating the deployment and actual release, there is a lot of risk avoided. The actual product release can be announced at the right time – as per Market demand/ after a robust Beta has been done and feedback incorporated/timed with a compliance deadline or important milestone like tradeshows.
  • Post-production Support: Releasing working software at regular intervals is not the end of the road. Customer Support, training and customer documentation where required is necessary and these activities should also come under the purview of an Agile Working environment.
  • Beta and Canary Release: Large Enterprises engage with Beta customers to get focussed feedback on the product before a wider market release. Solutions and products can also be released to a particular market segment or a subset of users alone. This is called a “Canary Release”. This phased approach rather than a big bang approach will ensure the risk level is reduced and the quality of the product and credibility of the Enterprise is maintained.

How is an Agile PM different from the Conventional PM

The roles and responsibilities of a conventional Project Manager is now distributed amongst the Scrum Teams, Scrum Master, Product Owner and the Agile Project Manager.

But the most important but subtle difference between the Conventional PM and Agile PM is the mindset.

The Agile PM is a Servant Leader who wants to create a self-empowered self-organized team. He/she creates an agile environment where everyone is accountable, there is no fear of failure but the willingness to learn and continuously improveThe Agile PM avoids the traditional Command and Control approach where decisions are taken for the teams. .  There is also a conscious effort to decentralize decision making so that decisions are taken closer to where work is done. There is always an emphasis for visualization of work and transparency.

Go-to Traits for a Successful Agile Project

  • Self-Organized TeamsSelf-organized teams that are empowered and largely self-sufficient is an important facet of Agile. Teams are used to conventional ways of working where they look up to their superiors for decision making. Decentralized decision making will help largely to create empowered teams
  • Responsive to Change: creating empowered teams enable them to respond to change responsibly with minimum red tape.
  • Quick Feedback Loops: Agile thrives when there are quick feedback loops established so that teams can adapt to change based on informed decisions.
  • Continuous Improvement: Learning from the past and resolving not to repeat mistakes is an important facet of Agile teams. Retrospection at end of every iteration and release is highly recommended.
  • Business Agility: It would not be enough if engineering teams are agile and churn out software seamlessly. “Building the product right “is not sufficient and the teams should “Build the right product”. Solutions and products have to meet the customer needs and solve Customer Problems.  All functions such as product management, marketing, sales HR have to come into the purview of Agile Principles and Values to achieve the kind of Business Agility that is required to be Customer Centric and deliver value.

In conclusion, Agile is a paradigm shift from the phased traditional waterfall methods which run on detailed plans laid well aheadAgile Project Management is the need of the hour considering the rapidly changing market scenario, disruptive technologies and the ever- growing competition.

Before embarking on Agile projects organizations have to invest the time and effort to create a conducive Agile Work environment. The bare basics of Agile training and creation of small Agile teams (5 to 9 members recommended) with the vision to make the teams self-organized need to be in place. Agile Coaches and Change agents have to be identified to ensure the Agile transformation starts and keeps pace with small strides and does not die a natural death with teams, business and leadership falling back to traditional waterfall methods in the name of agile.

Radhika

Radhika Subramoniam

author

The author is an Agile Consultant working in the areas of process consultation and Agile coaching and transformation. She has been part of the software product development industry spanning field service, fleet management, telecom billing and network management.
